Project Updates
July 18
Schedules are subject to change due to weather and material/equipment availability.
Know before you go! Check UDOT Traffic before hitting the road.
In observance of the Pioneer Day Holiday on July 24, crews will suspend construction activities starting at 3:00 p.m. on Wednesday, July 23 through 5:00 a.m. Monday, July 28. All traffic control will remain in place.
The project hotline will be monitored during this time for any safety related issues. 385-383-6576
Upcoming Impacts
1800 North
Starting July 18, 2025, the sidewalk on the north side of 1800 North between 250 West and Main Street will reopen. The sidewalk on the south side of 1800 North in this area will be closed as crews continue the road widening project in this area.
Pedestrians should use caution and follow posted detour signs.
Starting Sunday, July 20, 2025, no parking will be allowed on 1800 North due to construction activities.
Crews will be shifting traffic to the north edge of 1800 North and work on widening the road on the south side of of the street.
Various utility installations will require intermittent side street closures. Rely on the on-the-ground signage for accurate detour routes and use adjacent side streets to access 1800 North.
Ongoing Impacts
I-15
I-15 northbound has been reduced to 11' lane width. Wide loads should use caution driving through the area.
In the area east of I-15, crews are building up the road and installing new retaining walls for the new interchange, as well as installing new water, sewer, and storm drain lines under the future I-15.
Crews are also installing conduit for UDOT’s fiber optic and communications system and installing the walls that will support the bridge to carry future I-15 traffic over 1800 North.
Main Street
Traffic has been shifted to the east side of Main Street between 2000 North and 1600 North while crews remove the old road and install new water lines.
Installation of new signal pole foundations and electrical meters on Main Street at 1800 North is ongoing.
Utility and other work continues on the shoulders of Main Street. Drivers and pedestrians should use caution in work areas and be prepared for shifting traffic patterns. Watch for closures and follow detour signs.
1800 North
Installation of new traffic signal foundations continue at 250 West, 1000 West, 1500 West, and near 1800 West.
Water and sewer line installation continues. Adjacent property owners will be notified of anticipated water interruption prior to work taking place.
Traffic along 1800 North between 300 West and 630 West will be reduced to one-way traffic, managed by flaggers, while crews haul material north-south across 1800 North through the remainder of the summer. Drivers can expect traffic to be held for 1 – 2 minutes at a time. This work will take place between 7 a .m. – 4 p.m.
Utility work continues along the entire corridor with the dozens of utility companies with infrastructure along 1800 North.
From the driver’s eye view, this can look like repetitive work – digging up a trench, laying pipe, compacting it, and doing it all over again for the next service. The network of pipes and conduit under the road can be as congested as the cars that drive on top of it. Additionally, utilities have spacing requirements to keep clearance from other pipes in their final placement.
It is critical to complete this work before pavement replacement to prevent future impacts to the roadway.
Area residents may experience an increase in construction related noise, dust, and vibration.
Closures
Sunset City Central Park

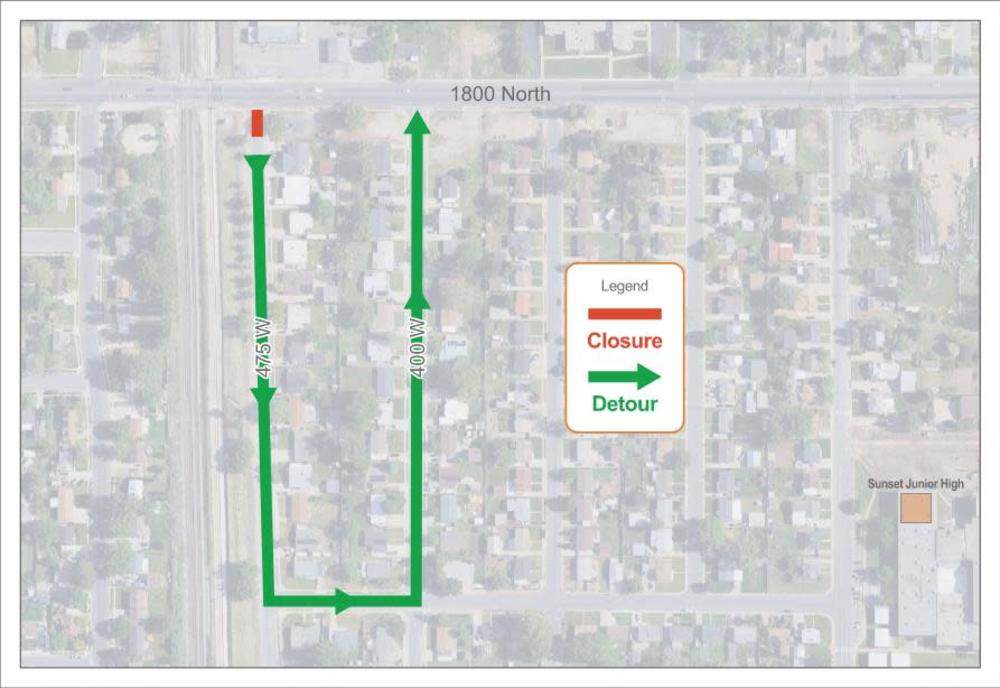

Access to the Sunset City Central Park will have short-term access closures on 1800 North while crews install a new water line on the south side of 1800 North. When the driveway is closed, use 250 West to 1675 North to access the park.
