Overview

Project Overview

The Utah Department of Transportation (UDOT) is adding more travel lanes on U.S. Highway 189 (US-189) between Wallsburg and Charleston to reduce congestion and increase safety for drivers. This is the last stretch of US-189 in this area with only one lane each way. When finished, US-189 will have two travel lanes in each direction from Provo to Heber City.



The main focus of the project is building the new travel lanes into the eastern hillside as a separate and elevated road, known as a split highway, similar to sections of US-189 in Provo Canyon. An example of what the split highway could look like when finished is shown below.

Other key features being built with this project include:

  • New traffic signal at the intersection of US-189 and SR-113

  • Improved access and parking at the Island Beach Day Use Area, including longer acceleration and deceleration lanes and a new parking lot

  • Better sight lines through the curved section along US-189

  • New wildlife fencing to protect drivers and animals

Construction started in October 2025 and is expected to wrap up in the fall 2027.

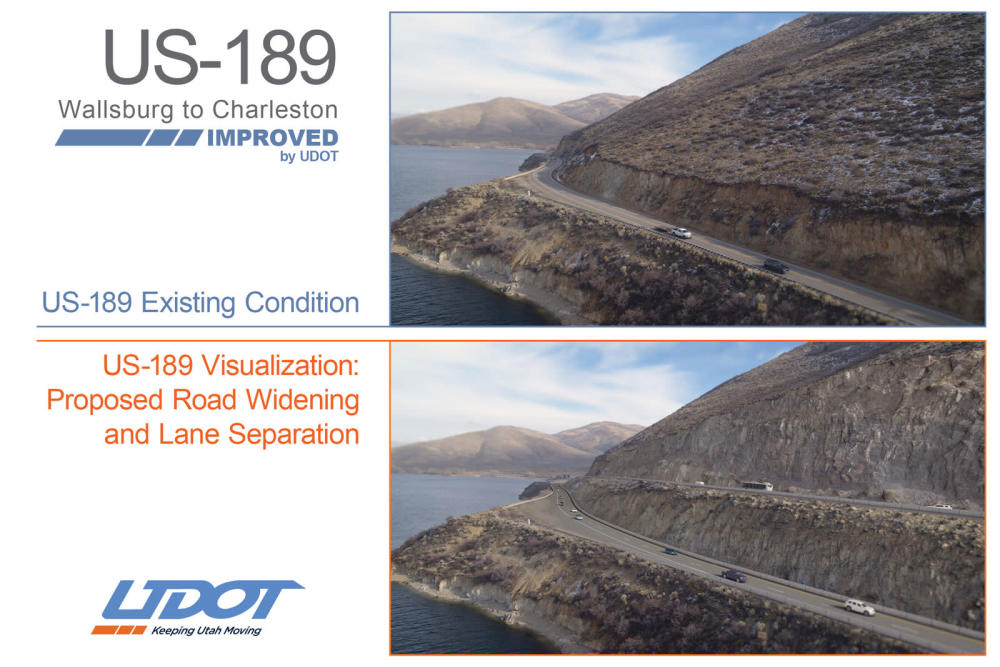

US-189 Existing and Split Highway VisualizationVisualization: Split Highway PIN: 15731

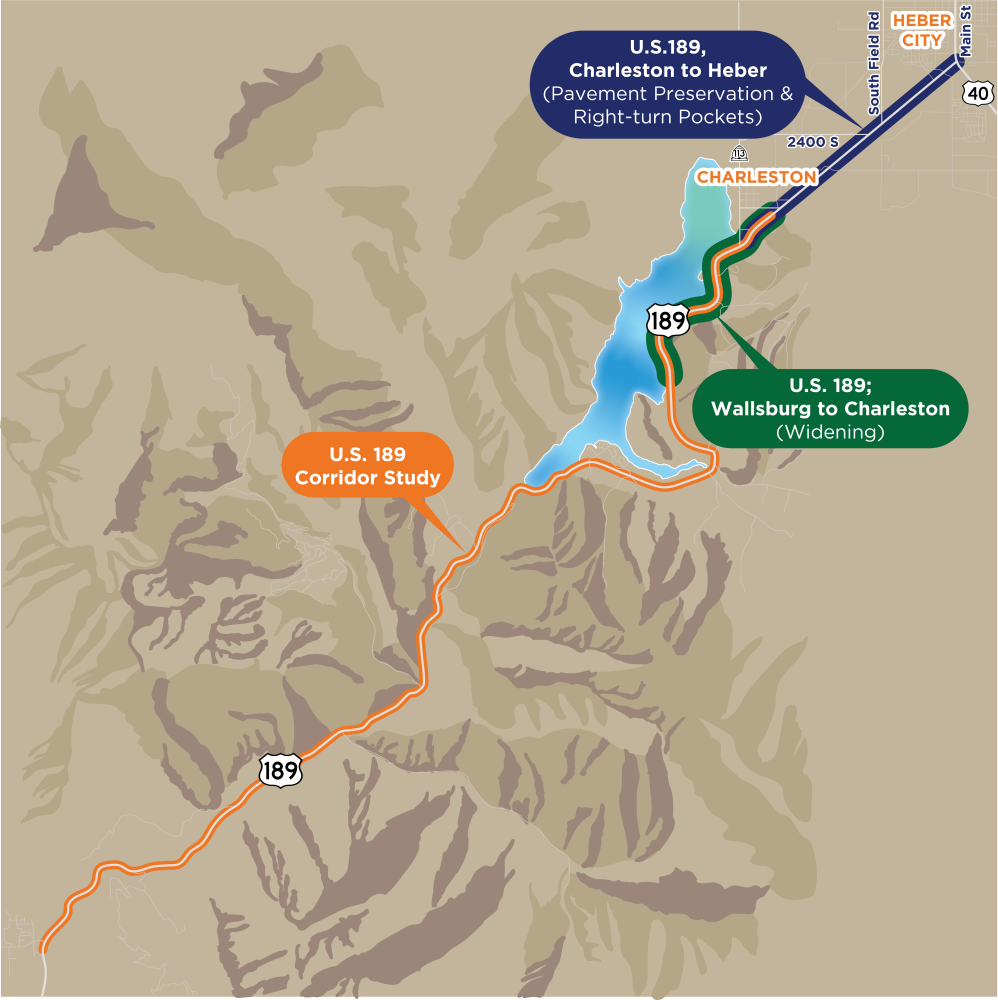

US-189 Wallsburg to Charleston Construction Area Map

Project area map PIN: 15731

Schedule

*Schedules outlined below are subject to change due to weather conditions and material availability.

    Contact Information

    To contact the public information team with questions or concerns:

    Stay Informed

    To receive email updates, please fill out the form at the very end of the Impacts & Updates tab or email** the public information team at HeberValleyProjects@utah.gov and type "Updates" in the subject line.

    **You are signing up for updates from all Heber Valley projects.

    Project Timeline

    live
    live

    Active Construction

    Northbound Lanes Reconstruction (Fall 2026 – Winter 2026)

    • Paving and striping on new pavement
    • Working on guardrail and signage

    Island Beach Area Undercrossing (Fall 2026 – Winter 2026)

    • The Lake House Restaurant at Deer Creek remains open during construction
    • Paving operations
    • Construct future parking lot

    Southbound Lanes Reconstruction (Fall 2026 – Summer 2027)

    • Shift all traffic to new northbound lanes

    • Improve sight distance through curved sections of US-189

    • Replace pavement

    • Improve access and parking at Island Beach Day Use Area, including extended acceleration and deceleration lanes

    planned
    planned

    Upcoming Construction

    SR-113 & US-189 Intersection (Summer 2027 – Fall 2027)

    • Build new road alignment
    • Install new traffic signal and complete intersection improvements

    complete
    complete

    Project Milestones

    • Traffic switched to new pavement at SR-113 and 3600 S (Summer 2026)

    • First Phase of Controlled Blasting and weekly closures (Early Winter 2026)

    • Project advertised and contractor selected (Summer 2025)

    • Final design and construction plans (Fall 2021 – Spring 2025)

    • Environmental analysis and documentation (Fall 2021 – Spring 2024)

    • Public hearing and comment period (Spring 2024)
