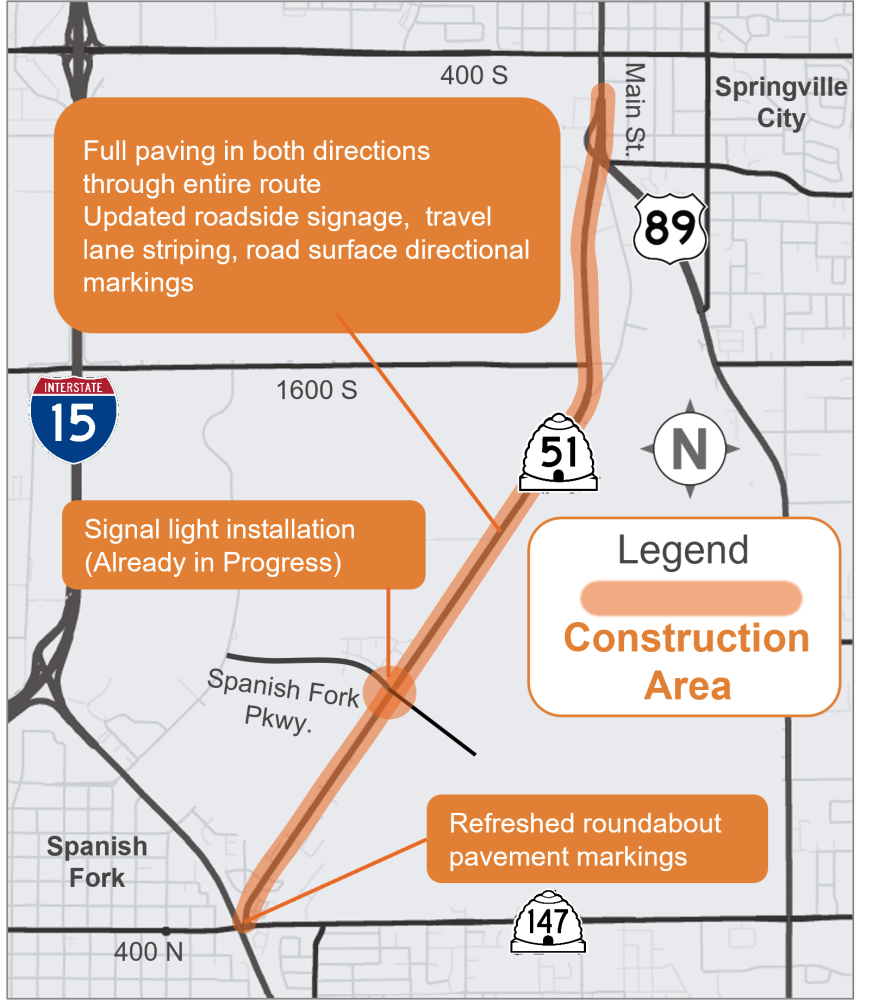

Project Description

The Utah Department of Transportation (UDOT) will resurface State Route 51 in Utah County from State Route 147 (400N) Spanish Fork to Main Street in Springville City.  The project objectives are aimed at preserving the life of the roadway.  The chip seal and fog coat resurfacing process will help increase the longevity of the road surface, address roadway defects and enhance motorist safety by providing good skid resistance for vehicles. Additionally, a signal light will be installed at the Spanish Fork Parkway intersection.





Schedule

Work Hours: Sunrise - Sunset

Workdays: Monday - Friday

Schedules are subject to change due to weather conditions and material availability.

complete
complete
March 15: Spanish Fork Parkway Int. Improvements

Details:  This work includes the installation of pedestrian ramps, signal lights, and road widening on the East side of the intersection.  Additionally, Spanish Fork Parkway will extend East bound past SR-51.

complete
complete
May 2 - 4: Misc. Patch and Road Prep

Details:  The majority of this road patch work will occur from the mid and northern sections of the route.  Moderate traffic delays are expected.

All patching to repair potholes and other major roadway deficiencies along the route will be completed.  Additionally, all new and updated roadway signs will be installed.

[ see Impacts & Updates tab for traffic ]

complete
complete
Project Suspension

In order to facilitate ongoing coordination with Spanish Fork City on the planned intersection improvements at Spanish Fork Parkway, the SR-51 paving project will will remain ON-HOLD until late July.



complete
complete
Aug 7: Final Paving Begins

!!  Shoulder Parking Not Allowed !!

This work should last approximately 10 days.  However, the bulk of the heaviest delays will occur between Monday, Aug. 7 and Friday, Aug. 11.   Moderate to heavy traffic delays are expected.  Painting and striping work begins the week of Aug. 14 with short distance flagging operation.

[ see Impacts & Updates tab for traffic for alternates ]



complete
complete
Mid-August: Construction End

Note:  Crews will return 30 days after construction completion(~September) to apply a second coat of  travel lane paint lines.
