Overview

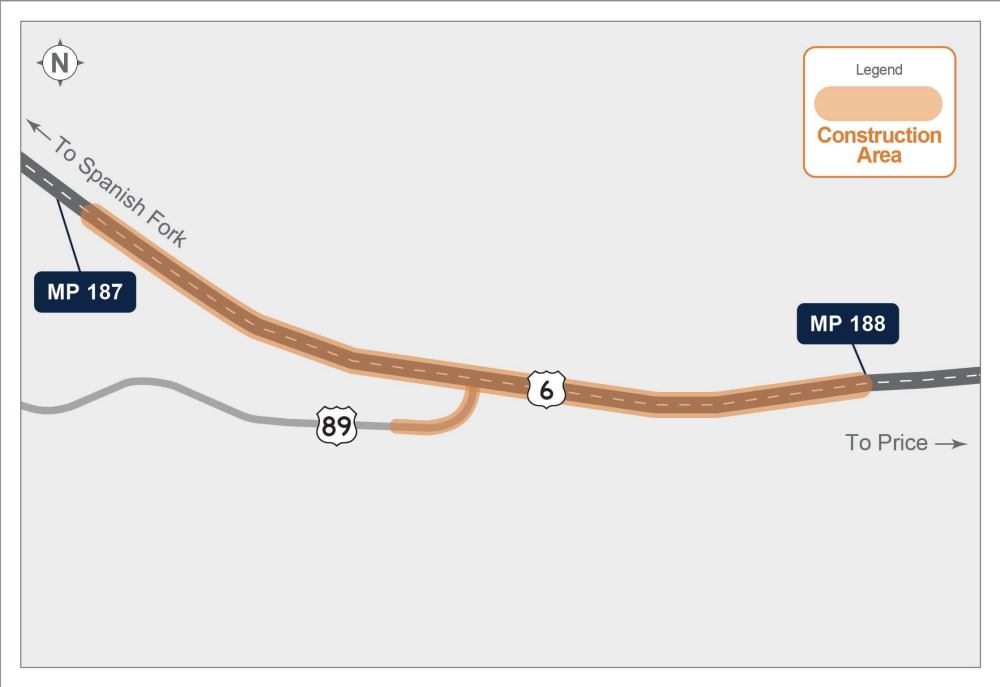

Map of the project area for the US-6 and US-89 safety improvements. PIN 22192

Project Overview

Construction will begin in April on safety improvements to the U.S. Route 89 (US-89) and U.S. Route 6 (US-6) intersection, also known as Thistle Junction.

The project will replace the existing T-intersection with a grade-separated interchange to improve safety. US-6 will be kept at the current grade, and US-89 will be routed through a new underpass underneath US-6. Crews will also build new on- and off-ramps for US-6 and US-89 to provide safer, more efficient merging movements for drivers.

Key improvements include:

  • Constructing an underpass for US-89 to provide a grade-separated crossing for traffic
  • Reconstructing turning movements with longer acceleration and deceleration lanes

The project team plans to have a fully functioning interchange open by mid-November 2026. Additional work will take place in Spring 2027 after a winter shutdown.



What to Expect

Construction began on Monday, April 27.

Work hours are 7 a.m. to 5 p.m., Monday through Saturday.

Beginning in early May, traffic on US-6 is anticipated to be reduced to one lane in each direction at all times and shifted to the north so the earthwork and bridge construction can be done on the south side. Travel through the junction will be maintained in all directions on US-6 and US-89 throughout construction, but capacity will be reduced to a single lane in each direction.

We anticipate this lane restriction will create delays, especially at peak travel times. To minimize your inconvenience, we encourage you to:

  • Select alternate routes whenever possible.
  • Adjust your trips to avoid peak travel times.
  • Use zipper merging at the lane restriction to get through the work zone as quickly as possible.
  • Check the UDOT Traffic Alert system for current travel conditions at www.udottraffic.utah.gov/.

Schedule

Work Hours: 7 a.m. - 5 p.m.

Work Days: Monday through Saturday

Project Timeline

live
live

Construction: April to November 2026

Construction will begin on April 27 and is expected to last through mid-November.

Crews will be working mainly on the shoulders from April 27 to May 7, placing temporary paving to widen US-6 in preparation for shifting traffic to the north.

planned
planned

Construction 2026-2027

Beginning May 8, US-6 traffic will be restricted to a single lane in each direction at all times until the new interchange is completed in November.

Additional construction activities are planned for Spring/Summer 2027.

complete
complete

Design

Project design was completed in Winter 2025 - 2026.

Contact Information

To contact the public information team with questions or concerns:

Hotline: 801-738-8149

Email: US6ThistleSafety@utah.gov

Stay Informed

To receive project updates, please contact the public information team at the email address above and enter "Project Updates" in the subject line.

Or click the "Sign up for Updates" tab and complete the online form.
