PROJECT UPDATES

Construction Activities May 1 - 31



Know before you go! Check UDOT Traffic before hitting the road.

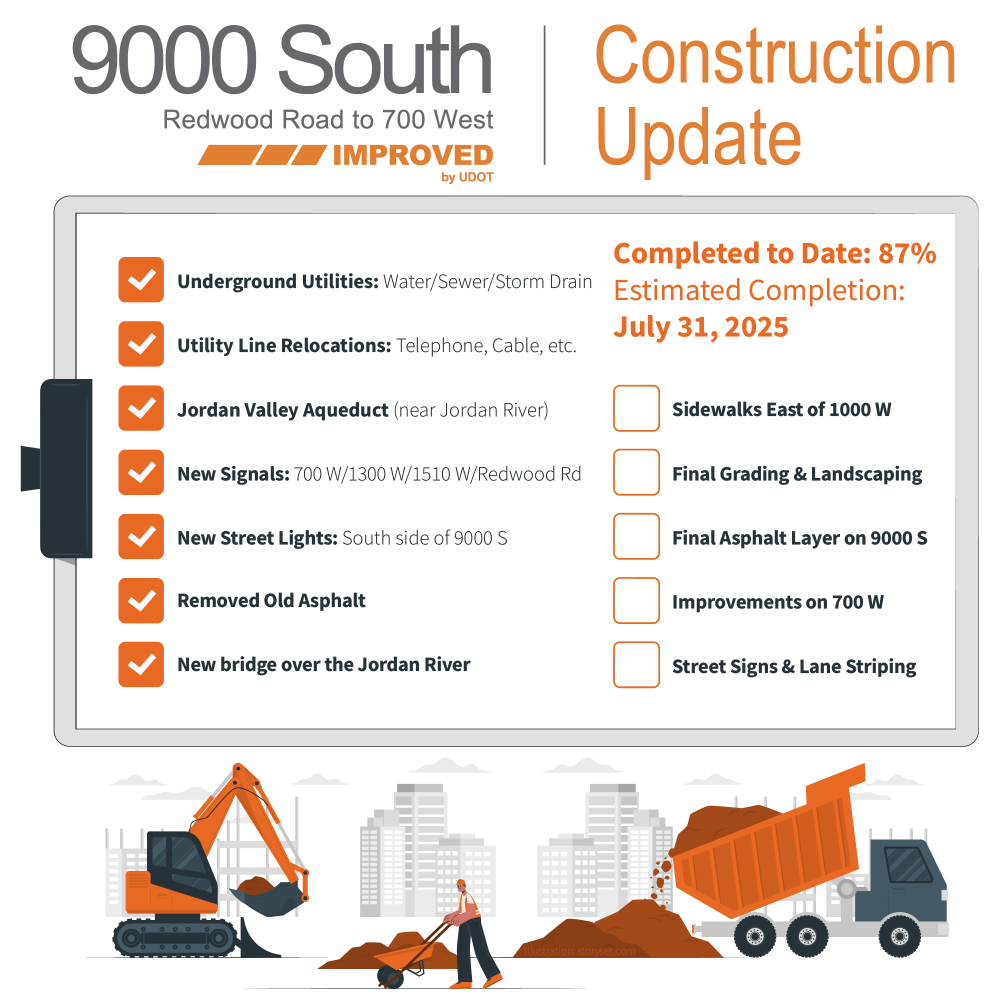

This infographic shows what work has been completed and what work remains.

Upcoming Activities

State Street to 700 West

As early as Sunday, May 18, crews will begin overnight work to install grooves into the asphalt for the permanent lane marking. Lane lines will included retroreflective roadway marking tape to improve lane line visibility. This work will take place between 8:00 p.m. and 6:00 a.m. the following morning for two weeks (excluding weekends).

As early as Monday, May 19, crews will remove and replace the ADA pedestrian ramps on the north side of 9000 South in front of the LithoFlexo and Abundant Dental businesses. Patrons and employees should access the businesses from 700 West. The closure will last up to two weeks.



700 West to 900 West

700 West is open for NORTHBOUND traffic only with all southbound traffic detoured at Sandy Parkway. Crews continue installing upgraded storm drains, new asphalt, additional sidewalks, curb, and gutters. Local two-way traffic will be allowed between 8400 South and 8800 South. Click here for the detour map. 700 West is anticipated to reopen by May 16 with all work completed by the end of May (weather permitting).



900 West to Redwood Road

Driveways to businesses on the southside of 9000 South have been closed while crews prepare to repair the asphalt driveway approaches. On Saturday, May 3, crews will replace the asphalt for these business driveways. While the driveways are closed, use accesses on 1300 West, 1510 West, and Redwood Road as alternate accesses. The accesses should reopen by the end of the day on Saturday.

Overnight Thursday, May 15 and again on Friday, May 16 (8:00 p.m. through 6:00 a.m.), crews will shift traffic on 9000 South into the center of the road. This will allow crews to work on the shoulder areas on both sides of 9000 South to complete necessary work.

As early as Monday, May 19, crews will remove the remaining old asphalt near the River Oaks Golf Course Driving Range on 9000 South requiring driveway access closures. Patrons to the driving range should park at the main clubhouse (9300 South Riverside Drive) for driving range access.

Work continues near the Jordan River on a water line for Jordan Valley Water.

Crews are installing curb, gutter, and sidewalks on the north side of 9000 South near the Jordan River.

*Schedule is subject to change due to weather, equipment, or material delays.



Closures

Eastbound 9000 South left turn closed at 700 West

The left turning lane to 700 West from eastbound 9000 South will be closed. This closure is expected to last through Summer 2025. Traffic should use Sandy Parkway (450 West) as the detour route. Click here to see the recommended detour map. This closure is necessary to ensure safety as there is insufficient room to install a left-turning lane.



Patrons to the River Oaks Driving Range may only enter and leave eastbound on 9000 SouthDrivers should not drive into the work zone as hazards may be presentClick here for the detour map.



Transit and Traffic Information

UTA LogoUTA Bus Route F590 - Due to construction activities, the bus stops within work areas may have temporary closures and stop adjustments. Visit UTA's website for specific stop information



Know before you go! Check UDOT Traffic before hitting the road.

Question title

Receive Project Updates

If you would like to receive project updates, please enter your information below:

By entering your information, you will be signed up to receive project updates as they are released.

Miscellaneous Information

Bridge Girder Placement

See the time lapse video of the crews placing the girders on 9000 South over the Jordan River.

Bridge Deck Concrete Pour

See the time lapse video of crews pouring concrete for the southern deck of the bridge over the Jordan River.

Contact Information

Hotline: 855-925-2801 Project #5626
Email: widen9000south@utah.gov

Schedule

complete
complete
Project Design:

complete
complete
Environmental Evaluation: Spring 2019 to Summer 2020

complete
complete
Right of Way Acquisition: 2020 to 2021

complete
complete
Advertise: January 2023 to March 2023

Receive bids from potential contractors

Dry Creek was selected as the contractor for the project.

complete
complete
9000 S Open House Meet the Contractor

June 28, 2023

5:30 PM - 7:30 PM

Riveside Elementary School

8737 South 1220 West, West Jordan

live
live
Start Construction: July 5, 2023

Work Hours: 7 a.m. - 5:30 p.m.

Workdays: Monday - Friday

Schedules are subject to change due to weather conditions and material availability.

There will be some night work and weekend work as part of this project.

planned
planned
End Construction: July 31, 2025
