I-215 W 2700 S Bridge Work

On November 4, 2023, an excavator transported on a tractor hit the bridge girders on the southbound side of I-215 W at 2700 S - damaging the bridge structure. An inspection revealed the bridge is safe for traffic to use, however, repairs are needed.

This project will repair the damaged bridge structure including removal and replacement of a portion of the damaged girder and repair of the adjacent bridge deck.

Repair work is planned to start September 24, 2024 with work lasting through mid-November.

Excavator underneath I-215 w 2700 S bridge after collision   Excavator underneath I-215 w 2700 S bridge after collision

   Pictures of the damaged bridge deck.

Photo credits Utah Highway Patrol, Utah Department of Transportation





Area Map

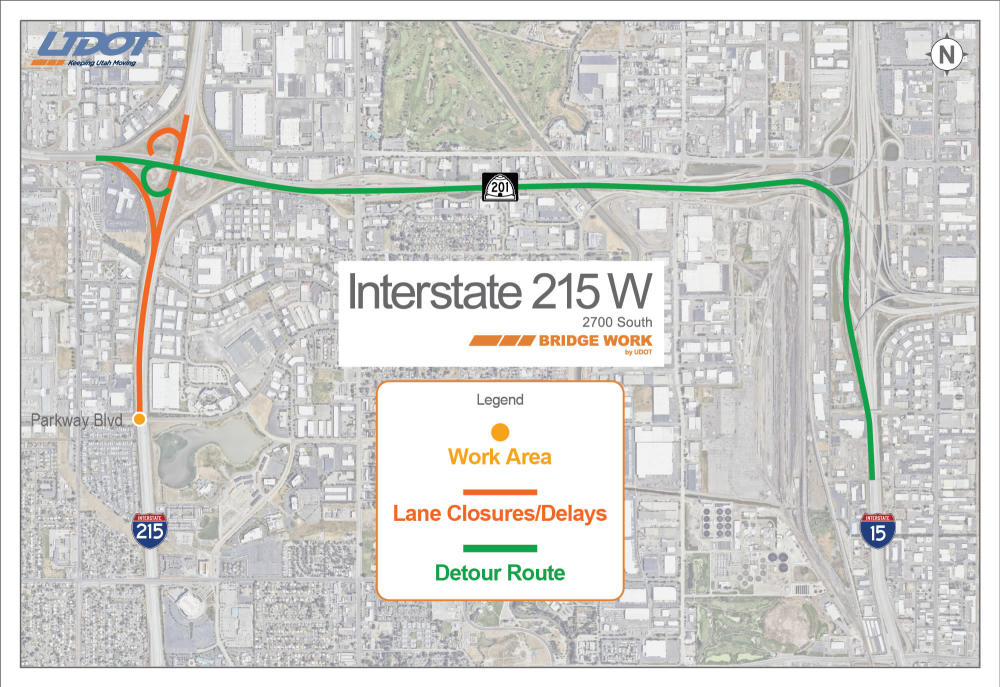

Map of bridge repair at !i-215 W at 2700 South

Schedule

live
live
Construction Start: September 24, 2024

Work Hours: 24 hours

Workdays: Daily

Schedules are subject to change due to weather conditions and material availability.



live
live
Winter Hiatus

As final work requires minimum temperatues consistently over 50 degrees, work will be suspended until spring 2025.

planned
planned
Construction Complete: May 2025

Contact Information

To contact the public information team with questions or concerns:

Hotline: 855-925-2801 Project #7236

Email: i215w2700sbridgework@utah.gov

Stay Informed

To receive weekly construction updates, please contact the public information team at the email address above and enter "Weekly Updates" in the subject line.
